Tuesday with a rail train.
A cold and bright day for a the gang of 7 who assembled to join a train loaded with new (- better second hand) rail for Dixton cutting.
Overnight the temperature had sunk to zero first thing this morning, but things brightened up considerably under the all day sunshine we had. Provided you didn't stand in the shadows, where the cold persisted.
Winchcombe forecourt was crammed with production vehicles for the BBC, as was Toddington upper car park, and indeed all the way down the drive right up to the gate, both sides. Filming took place at the entrance to Winchcombe station.'X' marks the spot, the first rail to replace. 'Saint' Robert shows us where. |
A rail train from Toddington, two Landies and the Telehandler set off for Dixton cutting, starting at the northern end. We've got a short stretch of track there laid with sub standard second hand rail back in the 1990s. It's all in one area, so clearly from a batch delivered then. The rail has many 2 inch craters on top ('squats') and while these just produce a rumbling sound when the rain passes over them, it's a weakness in the fabric of the rail and could result in a break. It's held up 30 years so far, so we've had good value from it, but now we need to change it for better.
On Tuesday then we set out to unload the first of two wagon loads, using our new lifting beam.
My measuring wheel is broke, who will fix my measuring wheel? |
Full of confidence we gave Andrew our measuring wheel, but it turned out to be broken in two. A lash up with some white cloth didn't help. It needs some sort of a pipe to act as a sleeve to unite the two halves.
After a little wait on site - the opportunity for some banter and coffee drinking - the train turned up with our wagon. This whole exercise also gives the diesel department and the guards something interesting to do, so they were very enthusiastic.
On arrival the group had a site discussion on how this was all going to work. It was our first day with the new spreader beam.
In the picture Andrew is holding the sad remains of the measuring wheel.
The spreader beam came with the train, so the first thing to do was attach it to the forks of the Telehandler.
Then the first rail was lifted off. It went pretty well really, but there was clearly a learning curve, so we got more proficient as the day went on.
A worry was the room available behind the Telehandler, so the Camlocks were attached on long chains, which allowed a drop without the forks having to pass in front of the bogie wagon.
We also had 2 bullhead rails with us. These were dropped off 1/4 mile further north, which meant out of Dixton cutting and on top of the long and tall embankment.
Here there was a lot less room behind the Telehandler, as you can see from the position of the rear wheels. It's also apparent why we used those chains.
Lunch was taken 'al fresco' in typical PWay style. Unfortunately this restaurant was already fully booked, so we had to eat, buffet style, standing up.
Photographing the train (or indeed anything else that day) was difficult, due to the intense and low light, not forgetting the weed growth here.
Motive power for the day was 47 105, in its shiny new blue and yellow jacket.
It was probably nice and warm in there too. Most of us had it cold, standing in the shadows at the bottom of the cutting, where the sun didn't reach all day.
We slowly made our way up the cutting, laying pairs of FB rail, end to end. Of course we still have to place them. The ones with the squats are still good for modest use, such as the proposed carriage sidings at Winchcombe, in connection with the carriage shed that is on our wish list.
And then it was the last one, No.13. You can see here how awkward it is manoeuvering the Telehandler with that big spreader bar attached.
We measured the rail and painted a white line exactly in the middle. That was the aiming spot for the Telehandler operator.
Here you can see our work at the end of the day. 5 pairs of 60ft FB rail, with another pair of Bullhead dropped round the bend. We'll be back next week for another shipment of 14.
Such dedicated, selfless volunteers. It's called charitable work, chaps. |
On the way back, we passed this remote controlled flail working near 3 arches bridge. It does a good job.
Wednesday - Loading rail at Toddington & more
This report from one of our correspondents, out with the PWay gang at Toddington, and then at Broadway.
The 'Elk' bogie, emptied at Dixton on Tuesday, was loaded again with a second delivery of used rail.
This delivery didn't take too long as the Elk was already parked on the unloading road in the car park, and the delivery lorry had a HIAB, which was able to make use of our lifting beam.
This lot will go out, as earlier in the week, on the Tuesday.
With an afternoon to spare, the gang then went to Broadway to distribute the replacement rails unloaded a few weeks back at the bracket signal. They too faced the lunch time rain.
With two sets of iron men the rails were transported through the platforms of Broadway. One rail was carried on the cross beams, the other hanging from the chains. Two tons being moved by four people.
Lunch was held in the deserted platform under the canopy - cold, but at least dry. Everything was shut of course as there are no trains, but we do of course have our gala this weekend, so don't miss that.
After lunch the other pair of rails was moved north using the iron men. They are ingenious little contraptions, and work very well, especially in enclosed places like at Broadway.
And this is the end result - four replacement rails laid out along P2 at Broadway. While P1 was laid with new rail, as an economy measure in 2017 it was decided to lay the loop in second hand rail. A number of these rails now need to be changed, as 4 of them had defects, some so hidden only the ultrasound detector could find them.
Pictures, with thanks, from Walt.
The Usketeers brave the weather.
A lot colder last night, and when we started it was too cold to lay blocks - only 3 1/2 degrees.
Paul brought some seasonal mince pies, and John (hot) cross buns.
A generous volunteer from the Santa scheme came and gave us £10 for doughnuts! We accepted gratefully, but will put it towards cement. We'd rather not eat up the donations, unless offered in actual doughnut coinage.
It was a rail mounted cherry picker, on its way to Greet tunnel for one of our regular inspections.
To get Paul and Dave going, we laid out this row of blocks for them (on the right).

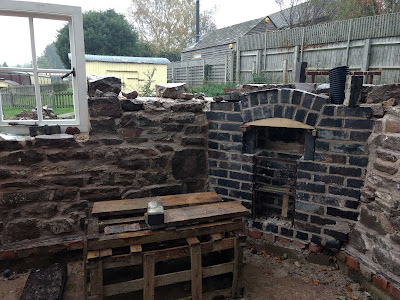

Can you see John inside the hut? Barely - it shows how high the walls are getting now.
Here we see Dave and Paul then, actually bedding down that row shown in the picture earlier.
Seen from the outside now, Paul too is looking short. He's standing on the foundation slab inside, two courses below damp course. Dave is on planks outside.
That little row of blocks was soon in.
It looks rather neat, don't you think?
Just as we were doing nicely, late in the morning, it started to rain. That hadn't really been forecast, so we held out in the drizzle for a while, but eventually cracked, and held an early lunch.
It was quite snug in the little lamp hut there, one man to each corner. John passed the (hot) cross buns around, and it was really a rather pleasant half hour, until the rain eventually receded again.
While Dave was pointing the row on the left, where he ran out of mortar at the end of last Wednesday, we laid out a new row for him on the right. There are 4 heavy ten inch high blocks in a row - got to get rid of them somehow - and these took a lot of effort to manoeuvre up there. The row is finished with a row of 5 inch blocks, to meet the quoin on the corner.
Walking back from the road bridge, we too a quick snap of the Usk site, as passengers will see it in the future.
There's definitely a stone building going up there.
Shortly after that we had another visitor, from station staff this time, and he also very kindly left a donation for a bag of cement. We get through about a bag a day.
This is our end of the day shot, with Dave working on that same row. The next heavy quoin for placement waits in the foreground. They're so heavy we need to use a little trolley to move them around.
In summary, we placed two rows today, on opposite corners of the building. The winter weather is going to start impinging on our progress now, with rain or frost potentially calling a halt. But next week still looks quite feasible, with slightly warmer temperatures again.
